This structured installation plan for Cladding systems in Glass,
Ceramic, Stone, Composite, Alu, Zinc, Terracotta, Pre-cast or GRC Panelling,
outlines our full-service approach from pre-installation assessments through
to post-installation support tailored to the diverse technical, safety, and
logistical requirements of modern systems. It reflects our commitment to
precision, regulatory compliance to ensure long-term performance across the wider
facade lifecycle.
We cover the following related services:
Pre-Installation
Phase
 - Project
     Assessment and Site Survey

 - Design
     Assessment and Coordination

 - Create
     and review the Safe Systems of Work

 - Delivery
     Schedule Coordination

Installation
Phase
 - Site
     Preparation

 - Layout,
     Marking and Substructure Installation

 - Insulation,
     Fire Barriers & Vapour Control

 - Cladding
     Panel Installation (Material-Specific)

 - Alignment,
     Adjustments and Testing

Post-Installation
Phase
 - Sealing,
     Waterproofing and Finishing

 - Cleaning,
     Detailing and Protection

 - Quality
     Assurance, Documentation and Handover

 - Client
     Training and Aftercare Support

Project
Management and Documentation
Throughout the installation process, our site teams maintain
detailed documentation of all activities, including daily logs, inspection
reports, and communication records. Our Site Managers will use adequate project
management forms to track progress and manage resources, to ensure the timely
completion of the project.
Our commitment
By adhering to this detailed and methodical approach to cladding system
installation, we ensure structural integrity, compliance with fire and thermal
regulations, and enduring visual performance. Our team delivers excellence
across all cladding types by following a code-of-practice-driven system that
leaves no element unaccounted for from safe design execution to final
handover.

                      This structured installation
plan for Cladding systems in Glass, Ceramic, Stone, Composite, Alu, Zinc,
Terracotta, Pre-cast or GRC Panelling, outlines our full-service
approach from pre-installation assessments through to post-installation
support tailored to the diverse technical, safety, and logistical
requirements of modern systems. It reflects our commitment to precision,
regulatory compliance to ensure long-term performance across the wider facade
lifecycle.
We cover the following related services:
Pre-Installation
Phase
 - Project
     Assessment and Site Survey


  - Analyse
      architectural and structural drawings, facade elevations, and cladding
      system specifications for all material types.

  - Survey
      site conditions, including substrate condition, verticality, access
      restrictions, crane/lifting paths, and weather exposure risks.

  - Evaluate
      transitions and junctions between cladding types, insulation systems,
      curtain walling, and fenestration elements.

  - Perform
      a site visit to review accessibility to workfaces and logistic
      requirements for the unloading, decanting and distribution of materials.


 - Design
     Assessment and Coordination


  - Coordinate
      with design teams to confirm panel dimensions, joint gaps, support rail
      positioning, and substrate preparation.

  - Ensure
      compatibility between different cladding systems (e.g., ceramic + zinc;
      stone + GRC) and verify anchor types and spacing.

  - Verify
      fire cavity barriers, thermal performance, and ventilation details as per
      statutory building regulations and tested system data.


 - Create
     and review the Safe Systems of Works


  - Develop
      and review comprehensive risk assessments (RAMS) that address the unique
      challenges of handling and installing large, pre-fabricated units,
      working at heights, and near heavy plant or pedestrian traffic.

  - Establish
      emergency procedures and ensure that all crew members are trained and
      briefed on best practices for handling and installing the systems.

  - Prepare
      detailed lifting plans considering the weight distribution and fragility
      of materials, using appropriate lifting gear to minimise potential
      damage.


 - Delivery
     Schedule Coordination


  - Schedule
      deliveries in line with the installation sequence, ensuring storage areas
      are secure and environmentally controlled where necessary.

  - Inspect
      all panels on arrival for edge damage, warping, or finish defects.

  - Store
      by orientation/type, installing sequence, and organise secondary lifting or
      distribution means for decanting heavy panel units individually where
      necessary.


Installation
Phase
 - Site
     Preparation


  - Assess
      the storage needs for tools and sensitive materials, lifting equipment
      and accessories, access requirements, PPE, consumables, safety barriers,
      man-safe systems, and any other necessary equipment.

  - Ensure
      crash decks, scaffold sheeting, and edge protection are installed as necessary
      on installation faces as detailed in the SSOW.

  - Ensure
      that installation zones are clearly demarcated with safety barriers and
      that all access points for crane or lift operations are established and
      secure.

  - Ensure
      all installation personnel are equipped with the required personal
      protective equipment (PPE), have the appropriate training and have been
      briefed on all required emergency and rescue procedures.


 - Layout,
     Marking and Substructure Installation


  - Use
      laser levels and datum lines to mark brackets, rails, or sub-framing
      positions. Check plumb, squareness, and spacing tolerance, ensuring the
      layout conforms to design drawings.

  - Account
      for expansion joints, tolerances, and aesthetic alignments across
      different building segments.

  - Secure
      brackets to substrates (steel, concrete, SFS) using approved anchors.
      Install vertical/horizontal support rails (T/L profiles or omega
      sections), adjusting for tolerances and thermal movement.


 - Insulation,
     Fire Barriers & Vapour Control



  - Install
      insulation boards (PIR, mineral wool, or phenolic), ensuring continuity
      with air/vapour membranes and foil tape sealing.

  - Ensure
      gaps are kept to a minimum around protruding elements and adhere to the
      building thermal specifications for each location.

  - Fit
      horizontal and vertical fire barriers as per the tested cladding system
      (e.g., ventilated rainscreen fire stops, compressible cavity barriers).

  - Seal
      the fire barrier slabs at their connection with the substructure, at
      joints, and the OSCI insulation on the back of the panels with foil tape
      to ensure the complete functionality and integrity of the fireproofing
      system.

  - Ensure the air gaps from the horizontal
      fire barriers to the cladding panels are kept to their designed size to
      ensure the functionality of the fire expansion elements for the
      ventilated cladding systems.

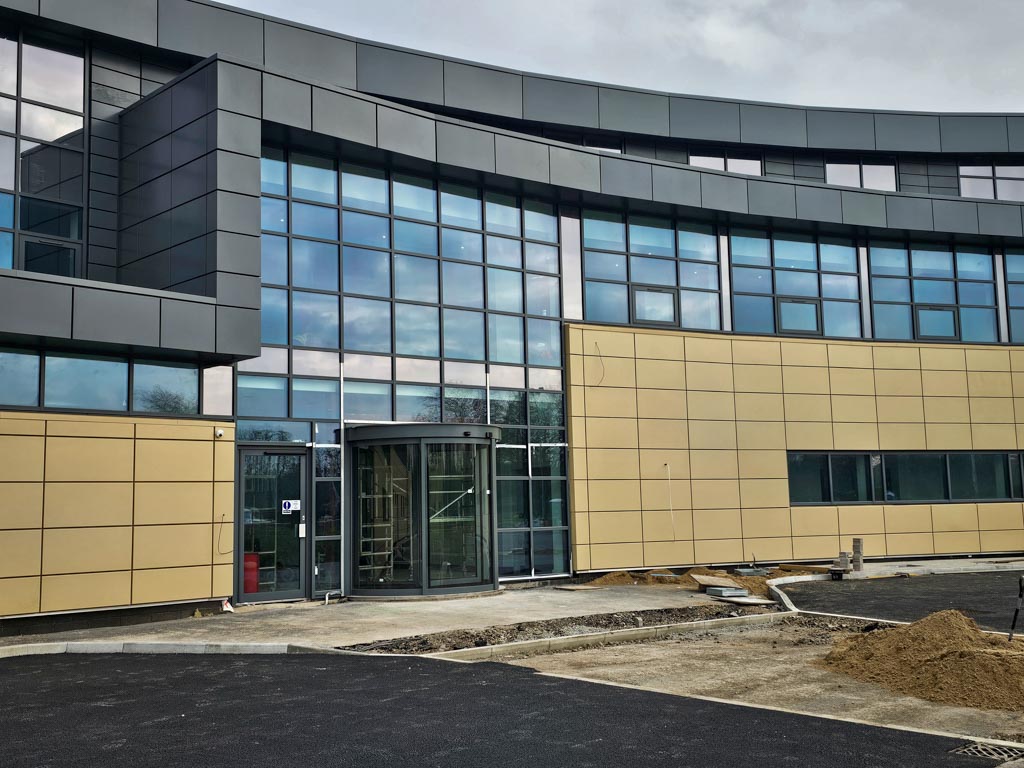

 - Cladding
     Panel Installation (Material-Specific)

Glass,
Ceramic, Terracotta:

  - Fix
      using concealed brackets, undercut anchors, or proprietary rail systems.

  - Maintain
      consistent open joints with gaskets or ventilation profiles.

  - Handle
      with suction lifters; avoid edge loading.


Stone, Pre-Cast & GRC:

  - Use
      pin brackets or stainless-steel fixings.

  - Use
      proper anchoring techniques to cope with thermal expansions and building
      movement.

  - Allow
      for movement joints and damp-proof courses.

  - Verify
      panel weight and sequence before hoisting.


Composite & Aluminium
Panels:

  - Rivet
      or hook-on systems over carrier rails.

  - Apply
      peel film removal sequencing and protect installed surfaces.

  - Adjust
      panel spacing and symmetry based on elevation layout.

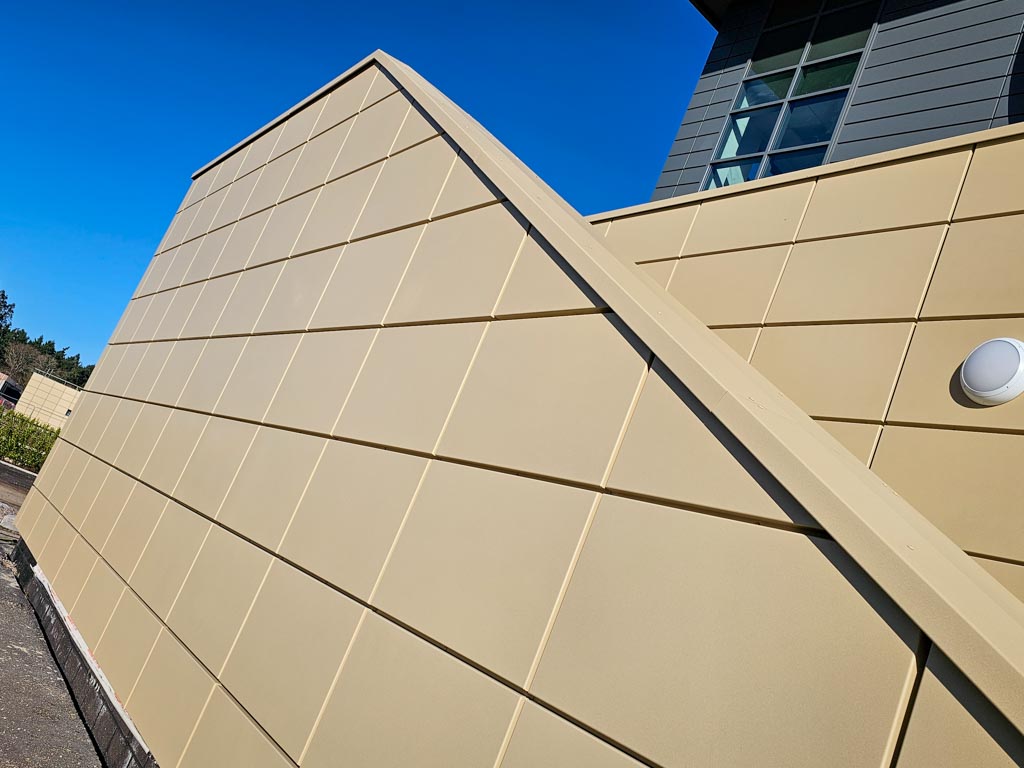

Zinc & Metal Panels:

  - Use
      standing seam or cassette systems fixed with stainless clips.

  - Seal
      end folds and flashings with breathable membranes or tapes.

  - Account
      for expansion, particularly in zinc, under temperature variations.

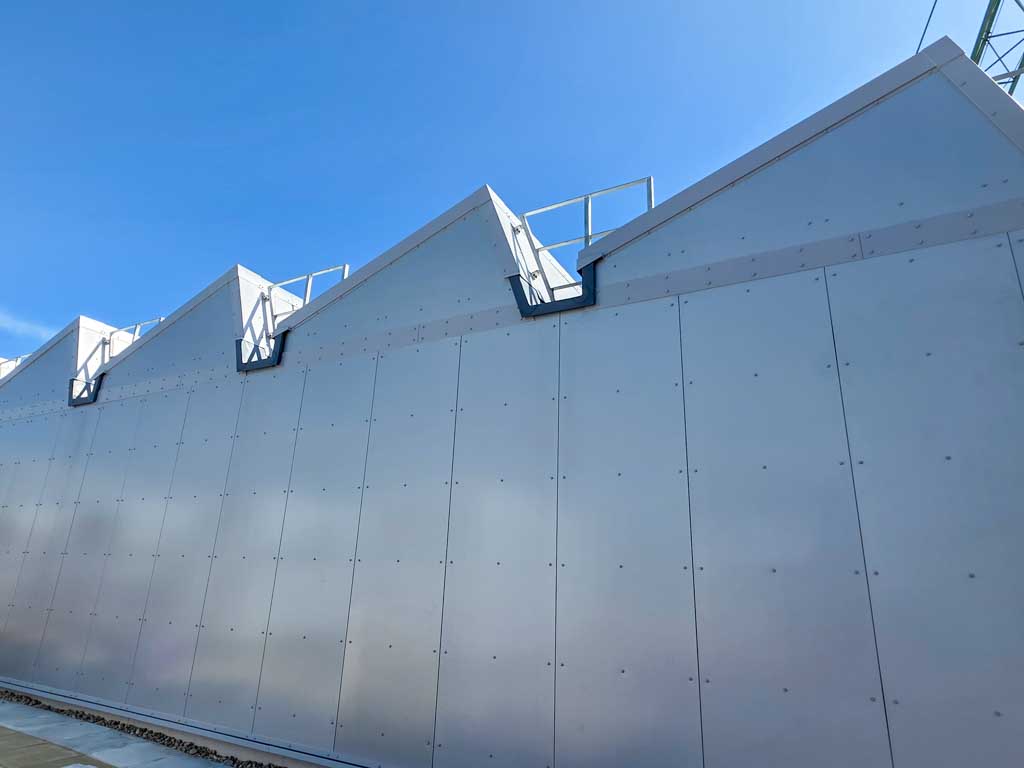

Built-Up & Rainscreen
Systems:

  - Assemble
      spacer systems, fix liners and install external rainscreen face.

  - Ensure
      ventilated cavity depth and continuous airflow path.

  - Maintain the manufacturer's tested joint
      spacing and detailing.


 - Alignment,
     Adjustments and Testing


  - Verify
      that all installed components are true to the design in terms of
      alignment, level, and spacing,
      making adjustments as necessary to correct any deviations.

  - Conduct
      pull-out tests, water penetration tests, or site-specific QA inspections
      (e.g., CWCT hose test) in line with the project ITP planning.


Post-Installation
Phase
 - Sealing,
     Waterproofing, and Finishing


  - Apply
      perimeter and joint sealants (silicone, EPDM, or hybrid) where required,
      using appropriate primers and backer rods.

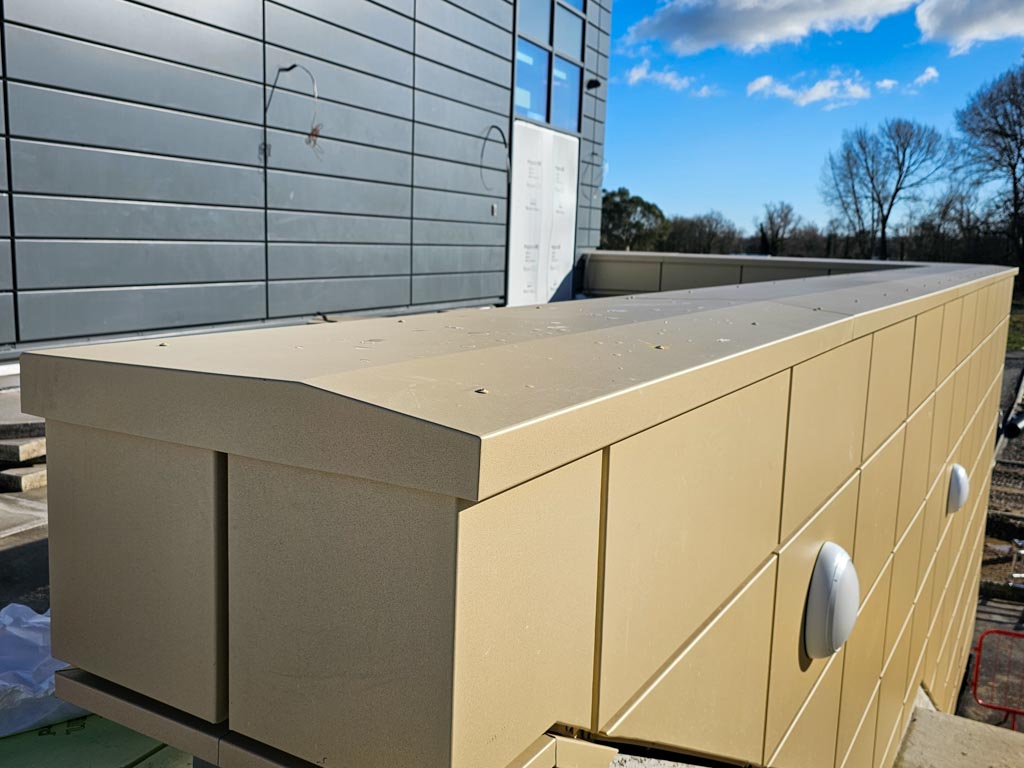

  - Install
      coping, corner flashings, parapet trims and drip details in sequence to
      complete weatherproofing.


 - Cleaning, Detailing and
     Protection



  - Clean
      all surfaces to remove installation debris, smudges, and marks using
      non-abrasive agents suited for the materials installed.

  - Inspect
      the edge details, joints, and trim elements to ensure a consistent,
      high-quality finish across the installed systems.

  - Leave
      protective films on panels until the area is safe from ongoing works.
      Apply temporary protection to exposed junctions.

  - Check
      for plumb, level, consistent joint widths, clean lines, and colour
      consistency.


 - Quality
     Assurance, Documentation and Handover


  - Carry
      out a comprehensive inspection against design and performance standards,
      verifying correct fixings, alignment, seal integrity, and overall finish
      quality.

  - Document
      any discrepancies or issues and address these prior to the final
      handover.

  - Prepare
      comprehensive documentation, including as-built drawings, quality test
      reports, maintenance guidelines, and warranty information.


 - Client Training and
     Aftercare Support


  - Provide
      the clients maintenance team with operational training on moving
      components (if applicable), routine cleaning, and inspection practices
      specific to each installed system.

  - Establish
      clear channels for aftercare support, including scheduled maintenance
      visits and prompt response plans for any issues related to the installed
      systems.


Project
Management and Documentation
Throughout the installation process, our site teams maintain
detailed documentation of all activities, including daily logs, inspection
reports, and communication records. Our Site Managers will use adequate project
management forms to track progress and manage resources, to ensure the timely
completion of the project.
Our commitment
By adhering to this detailed and methodical approach to cladding system
installation, we ensure structural integrity, compliance with fire and thermal
regulations, and enduring visual performance. Our team delivers excellence
across all cladding types by following a code-of-practice-driven system that
leaves no element unaccounted for from safe design execution to final
handover.
